Electricity Regulation Act, 2006 (Act No. 4 of 2006)RulesGrid Capacity Allocation Rules7. Grid Capacity Allocation Process Requirements |
| 7.1 | The grid capacity allocation process shall have three stages that include the pre-feasibility stage, reservation stage and allocation stage, as shown in Figure 1 below. |

| 7.2 | Pre-feasibility stage: An Applicant shall apply for a CEL with a relevant NSP and demonstrate project development intent, showing that they have started engagements with relevant authorities such as the Department of Environmental Affairs and landowners. |
| 7.3 | The Applicant should be able to determine the project location, size of the project in terms of Megawatts (MWs) and technology. |
| 7.4 | The Applicant shall also be required to pay a reasonable fee for the cost of the provision of a CEL. |
| 7.5 | The timelines for the provision of a CEL shall be in line with the requirements of the Grid Code, unless the NSP has a reduced timeline compared to those indicated in the Grid Code. |
| 7.6 | Reservation stage: The capacity shall be reserved for a project when an Applicant has accepted the CEL and has paid the CEL fee. |
| 7.7 | The Applicant must also provide proof of the following readiness documents: |
| (a) | Environmental authorisation for the generation site |
| (b) | Provision of a financial guarantee |
| (c) | Verified site resource data, such as twelve months site resource data for wind technology or satellite-verified data for solar technology |
| (d) | Proof confirming that it has applied for/obtained registration or a generation licence with NERSA. |
| 7.8 | Thereafter, the Applicant shall be required to apply for a BQ. |
| 7.9 | The BQ shall be accompanied by all the relevant agreements such as connection agreements and implementation agreements. |
| 7.10 | The timelines for the provision of a BQ shall be in line with the requirements of the Grid Code, unless should the NSP have a reduced timeline compared to those indicated in the Grid Code. |
| 7.11 | Allocation stage: The capacity shall be allocated to a project when it has proof of the following readiness documents: |
| (a) | When the BQ has been accepted and provision of financial guarantees related to project execution. |
| (b) | When the Applicant and an NSP have signed legally binding agreements such as a connection agreement(s) and/or implementation agreement. |
| 7.12 | The connection agreement(s) and/or implementation agreement shall contain the technical scope, project timelines, and the Commercial Operation Date (COD). |
| 7.13 | Construction schedules and Engineering Contracts may be submitted to the NSP to ensure the successful commissioning of the project. |

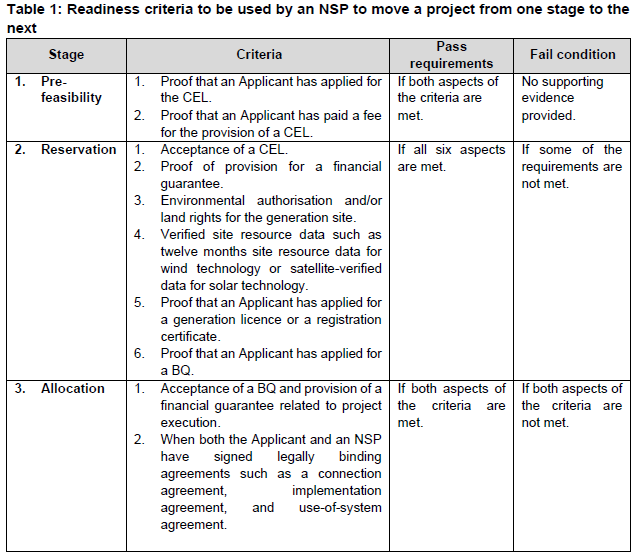

| 7.14 | The readiness of the three stages of the grid capacity allocation process shall be assessed by either a pass or fail condition based on the requirements/criteria emanating from each of the three stages. An NSP shall be required to use the readiness criteria illustrated in Table 1 to move the project from one stage to the next. |

| 7.15 | The approach set out in Table 1 supports the first-ready, first-served principle whereby a project will only move to the next grid capacity allocation stage when all conditions from a previous stage are met. |
